Mine / resource · China

Lakkor Tso

RampingVerified 24 Oct 2026As of 25 Oct 2026
Owner
Zijin Mining 63%, Xizang Geological & Mineral Group 27%, Ngari SOE 10% (via Tibet Ngari Lakkor Resources)
Listed via
601899.SS
Product
Li2CO3
Deposit type
Brine
Capacity
Phase 1 20 ktpa lithium salt in operation; Phase 2 +40 ktpa targeted end-2027; 2025 production 12,000 t LCE (project page); H1 2026 9,065 t LCE (H1 Interim)
≈ 20 kt LCE/yr (nameplate)
Location
32.05°, 84.21°
Source

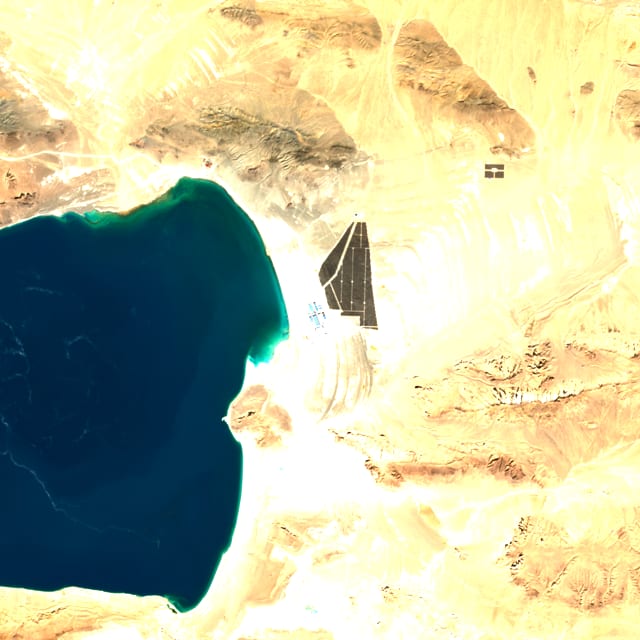

Gerze County, Ngari, Xizang. Lat/lon = plant compound centroid on Lagkor Co east shore (Esri WV-3, 10 Oct 2025). Adsorption+membrane; no ponds. EIA centre 32.06441,84.20167 ~1.9 km NNW unused. Corrects #237/#180.

Ownership structure

Effective economic interest of listed owners · As of 25 Oct 2026
Zijin Mining601899.SS63%Other / unlisted37%Lakkor TsoMine / resource

Attributable capacity

Listed ownerStakekt LCE/yr
Zijin Mining 601899.SS63%≈13

Structure: Zijin Mining 63%, Xizang Geological & Mineral Group 27%, Ngari SOE 10% (via Tibet Ngari Lakkor Resources). 37% is held by unlisted or untracked owners.

Value chain

Owners, buyers and the refineries on Li3atlas they feed · As of 25 Oct 2026
Mine / resourceLakkor TsoPhase 1 20 ktpa lithium salt in operation; Phase 2 +40 ktpa targeted end-2027; 2025 production 12,000 t LCE (project page); H1 2026 9,065 t LCE (H1 Interim)

Quarterly production

As of 30 Jun 2026
02.557.510UnverifiedUnverifiedUnverifiedUnverifiedH1 2026: 9.07 kt LCE9.07Q2 25Q3 25Q4 25Q1 26Q2 26Q3 26

kt LCE, as reported · Source:

H1 2026
Production (kt LCE)9.1

Country risk · China

Policy risk: Medium As of 24 Oct 2026

Change history

Approved changes with their source · As of 25 Oct 2026
DateFieldChangeSource
25 Oct 2026production_plannew: 2026: 20 kt LCE · Company 2026 production plan (Annual Report 2025); not a DFS/PFS schedule (as of 2025-12-31)
25 Oct 2026Quarterly figuresnew: H1 2026 · production 9.065 kt LCE
24 Oct 2026Map position32.064°, 84.202° → 32.049°, 84.212°
24 Oct 2026NotesGerze County (Mami township), Ngari, Xizang. Adsorption, membrane and electrodialysis process; no evaporation ponds. Lat/lon = project centre from the completion environmental-acceptance record; plant compound ~1.9 km SSE (32.0493, 84.2121, Esri imagery). Corrects #180 (lake centre). → Gerze County, Ngari, Xizang. Lat/lon = plant compound centroid on Lagkor Co east shore (Esri WV-3, 10 Oct 2025). Adsorption+membrane; no ponds. EIA centre 32.06441,84.20167 ~1.9 km NNW unused. Corrects #237/#180.
24 Oct 2026VerifiedValues confirmed
24 Oct 2026NotesGerze County, Ngari, Xizang. Location = Lagkor Co / Laguo Cuo lake centre (Mindat 32.08333, 84.16667); plant/pond complex is on the salar and should be within ~1–3 km — verify on satellite before map publish. H1 2026 Interim confirms 63% interest and production. → Gerze County (Mami township), Ngari, Xizang. Adsorption, membrane and electrodialysis process; no evaporation ponds. Lat/lon = project centre from the completion environmental-acceptance record; plant compound ~1.9 km SSE (32.0493, 84.2121, Esri imagery). Corrects #180 (lake centre).
24 Oct 2026Map position32.083°, 84.167° → 32.064°, 84.202°
24 Oct 2026Notesnew: Added to Li3atlas: Lakkor Tso
